Congo Lane Street Project

As part of the 2023 Bond Referendum the citizens of Jersey Village approved bonds for street projects, one of which was the Congo Lane Project.

This project was designed by Garza EMC and includes new street, sidewalks, storm sewer, water line, and street lights for Congo Lane from Senate Avenue to Equador Street.

The project was placed out to bid in March 2024. The following bids were received:

Bidder Bid Amount
Environmental Allies $2,950,512
R Construction $3,672,610.05
Cracon Inc $3,786,693.10
Teamwork Construction Services Inc $4,034,834
iCon GC LLC $4,260,000
MC2 Civil LLC $4,576,184.50
Conrad Construction Co LTD $4,850,523



During the April 22, 2024 City Council Meeting the City Council awarded the project to Environmental Allies.

Work is expected to begin at the conclusion of the 2023-2024 school year along Congo Lane from Solomon to Equador. That section of road is anticipated to be completed before the 2024-2025 school year begins in mid-August.

Project updates for this project will be posted below as they become available. If you would like to receive these updates via email please use the form at the bottom of the page to subscribe.

Frequently asked questions about street projects can be found here

Congo Lane Update
11/05/2024

Dear Residents,

Due to recent rain events, the contractor has been unable to begin work as originally scheduled. They will return once the ground has dried out and the risk of mud entering the streets is minimized.

The contractor plans to remobilize on Thursday and will resume work on the following tasks: driveways, sidewalks, relocation of water meter boxes, sprinkler systems, mailboxes, and sod placement. Weather permitting, these tasks should be completed by the end of January.

We apologize for the delays caused by these unforeseen weather conditions. Despite these setbacks, the contractor is committed to completing the project in January. Please note, the contract schedule extends from June 1, 2024, to June 1, 2025.

Thank you for your continued patience and understanding.


Congo Lane Update 10/31
10/31/2024
The contractor has completed the installation of all curbs along Congo, and both lanes are now open. Weather permitting, they plan to work this Friday to finalize the installation of mailboxes between Equador and Solomon. Additionally, a small crew will handle housekeeping tasks between Solomon and Senate.

Congo Lane Update Notification
10/25/2024

October 21-25: The contractor is currently pouring the final north section of pavement between Australia and Senate. Once the concrete has cured, they will begin installing curbs along this new pavement. On Saturday, they will repair one inlet location between Australia and Senate; this task will take only a few hours and will require a skeleton crew.

October 28-November 8: The contractor will focus on driveways in Section 1 and Section 3 (Equador/Solomon and Australia/Senate). They will also work on sidewalks in Section 1 and Section 2 (Equador/Solomon and Solomon/Australia). Additionally, curb installation will start between Australia and Senate.

November 11-28: The contractor will continue installing driveways and sidewalks, along with any necessary concrete repairs related to these areas.


Water Service Line Transfer Shutoff Notice
10/17/2024

Dear Residents,

We want to inform you about a scheduled water service line shutoff.

Date: Friday, October 18, 2024
Time: 9 AM - 5 PM
Location: Between Australia and Senate

During this time, our contractor will be transferring the old water service lines and all water meters to the newly installed line.

We appreciate your understanding and patience as we work to improve our water services. Thank you for your cooperation!

Best regards,


Weekly updates, October 7-18
10/15/2024

Dear Residents,

We would like to provide you with an update on the ongoing construction project in our area. To help alleviate potential issues and ensure everyone’s safety, we kindly ask that you park your vehicles in your driveway until the project is completed.

As a reminder, the existing light poles have been removed for the road widening, and new decorative lights will be installed after all concrete work is finished. Please note that driving in and out of driveways may be challenging at night. We are currently exploring options to add reflective lights (delineators) or barricades with flashers for better visibility between Australia and Senate.

We appreciate your understanding and cooperation as we work to improve our community and expedite this project. Thank you for your patience.

Project Updates:

Intersections of Congo/Australia and Congo/Senate

  • Water Line Installation: The contractor has completed the installation of the new water line. Pressure and bacteria testing will be conducted this week to ensure safety and functionality.
  • Concrete Work:
    • October 9-11: South lane concrete installation is complete; curb installation will follow.
    • October 14-18: Demolition, rebar work, and concrete pouring are scheduled.
    • October 17: Approximately 50% of the concrete pour for the north lane is scheduled, weather permitting.

Intersections of Congo/Australia and Congo/Solomon

  • Current Focus: The contractor is forming and pouring sidewalks that have yet to be completed.
  • Water Meter Relocation: Ongoing work to relocate all water meters to the opposite side of the sidewalk, moving them away from the Right-of-Way line.
  • Sprinkler System: Work on re-installing the sprinkler systems is ongoing.

Intersections of Congo/Equador and Congo/Solomon

  • Sidewalk Finalization: The contractor is completing sidewalks in front of the high school on the north side of the street.
  • Driveway Replacements: Several driveways are scheduled for replacement due to concrete issues identified during inspections.
  • ADA Ramps: ADA ramps at the intersection of Congo and Equador have been poured.

Thank you for your continued support as we make these improvements!

Best regards,



Tim


Weekly Update: September 30 - October
10/03/2024

Intersections of Congo/Australia and Congo/Senate

  • Water Line Installation: The contractor has completed the installation of the new water line. Pressure and bacteria testing will be conducted to ensure safety and functionality.
  • Upcoming Work:
    • October 7: Demolition of the remaining south lane pavement will begin.
    • October 8: Rebar installation is scheduled.
    • October 9: New concrete will be poured.

Intersections of Congo/Australia and Congo/Solomon

  • Current Focus: The contractor is working on forming and pouring driveways that have yet to be completed.
  • Water Meter Relocation: All water meters will be relocated to the opposite side of the sidewalk, moving them away from the Right-of-Way line.
  • Sprinkler System: Work on re-installing the sprinkler systems is ongoing.

Intersections of Congo/Equador and Congo/Solomon

  • Sidewalk Finalization: The contractor is in the final stages of completing sidewalks in front of the high school on both sides of the street.
  • Driveway Replacements: Several driveways will be replaced due to concrete issues identified during inspections.
  • ADA Ramps: Four ADA ramps are pending installation to ensure accessibility.

Update September 21-27
09/26/2024

Intersections of Congo/Equador and Congo/Solomon

  • The contractor is finalizing the sidewalks in front of the high school on both sides of the street. Following this, repairs to the sprinkler system and placement of sod will take place.
  • Five driveways need to be replaced due to concrete issues.
  • Four ADA ramps are still pending installation.

Intersections of Congo/Australia and Congo/Solomon

  • All driveways have been installed except for one at the intersection of Australia and Solomon, which will be completed once the last section of pavement is finished at the northeast corner of Australia and Congo.
  • Water services have been successfully transferred to the new system.
  • Sidewalk installation on both sides of Congo will commence once the contractor completes the section in front of the high school.

Intersections of Congo/Australia and Congo/Senate

  • Approximately 400 linear feet of pavement is scheduled to be poured on Friday, September 27th, for the south lane. Starting next week, the contractor will begin demolishing the south lane towards Senate Ave and continue with the installation of the water line. To protect existing oak trees, the contractor will use a boring method instead of open trenching. Pressure and bacteria testing will follow upon completion of this section.

Update September 12-20
09/19/2024

Current Work Progress:

  • Sidewalks, Sprinkler Systems, and Sod: The contractor is currently installing sidewalks, sprinkler systems, and placing sod for residents between Equador and Solomon. A concrete pour is tentatively scheduled for Friday or Saturday, depending on weather conditions.

  • Water Line Installation: The contractor is installing water line service leads for residents between Solomon and Australia, connecting the old water line to the new 8” water line. The installation of driveways in this block is also nearing completion.

Upcoming Work:

  • Demolition and Concrete Work: Starting next week, the contractor will begin demolishing the south lane between Australia and Senate in preparation for a concrete pour expected within the next two weeks.

  • North Side Water Line: On the north side of Congo, the contractor will finalize the installation of the 8” water line.

Thank you for your continued support!


Update: Temporary Water Outage September 19-20
09/18/2024

Dear Residents,

We want to provide you with an important update regarding the water service in your area.

On Thursday, September 19th, from 8:00 AM to 4:30 PM, a contractor will be transferring water service from the old existing water line to the new 8" water line. Properties in the affected area between Solomon St. and Australia St. may experience a water outage lasting no longer than 30 minutes.

Additionally, on Friday, September 20th, the contractor will be working on the water line at the intersection of Australia and Congo. There will be a temporary water shutdown from 9:00 AM to 1:00 PM, affecting only residents between Australia and Senate.

We appreciate your understanding and cooperation during this time. If you have any questions or concerns, please feel free to reach out.

Thank you!

Best,


Weekly updates, September 5-13
09/12/2024

North Lane is 95% completed between Solomon and Australia. The remaining portion will be finished once the laterals for the inlets are installed. All driveways have been poured except for one, which is scheduled for this Friday.

Weather permitting, the contractor plans to begin pouring driveways for the remaining residents on North Lane this Friday between Solomon and Australia.

The water line installation is progressing well, with only the section between the intersection of Solomon and Australia. This section will undergo bacteria testing early this week. Residents between Australia and Solomon will be notified in advance of any temporary water service disruptions during these tests.  Water pressure was completed on Wednesday and pressure remained constant for 4 hours.

The contractor is focusing on completing the pavement between Solomon and Australia. However, there are delays in repairing sprinkler systems and in forming sidewalks and curb inlets on the north side between Solomon and Ecuador. These tasks will be prioritized in the coming week.

Additionally, next week, the contractor will begin demolishing the south lane between Australia and Senate in preparation for the concrete pour. They will also continue installing the remaining 8” water line on the north side.


Weekly updates, September 1-7
09/05/2024

The City Manager has authorized Environmental Allies to work this Saturday, September 7th. The contractor will continue preparations on the north lane between Solomon and Australia in advance of the concrete pour scheduled for Monday at 8 a.m.

Weather permitting, the contractor plans to start pouring driveways for the remaining residents on the south lane this Friday. On a positive note, the main trunk line of the storm system between Australia and Senate has been successfully installed.

Please be aware that traffic will be challenging over the next couple of months, and we appreciate your patience during this time.

Water line installation is progressing well, with only the section between the intersection of Australia and Senate still to be completed. This final section will undergo hydrostatic and pressure testing once installed. Residents between Australia and Solomon will be notified in advance of any temporary water service shutdowns during these tests.

Due to the short week and afternoon rains, the contractor has experienced delays in repairing sprinkler systems and in forming sidewalks and curb inlets on the north side between Solomon and Ecuador. These tasks will be prioritized in the coming week.


Weekly updates, August 26-31
08/29/2024

Here's a summary of the weekly update:

  1. Inlets:
    • All inlets between Equador and the Solomon are now concrete.
    • The Congo south lane is 95% complete with concrete between Australia and the Solomon.
  2. Water Line Installation:
    • Ongoing between the Solomon and Australia.
  3. Storm System Installation:
    • 50% complete between Australia and the Senate.
    • Progress slowed due to afternoon showers expected this week and possibly the next.
  4. Contractor Preparations:
    • Straw logs have been placed along new and existing inlets to manage upcoming rain events.
  5. Upcoming Focus:
    • The contractor will prioritize finalizing the storm system installation between Australia and the Senate.
    • All available manpower will then shift to concrete work.

Updated Construction Schedule
08/22/2024
Congo Lane Project Schedule.pdf

Update: August 19 to August 30
08/22/2024

The City Manager has approved Environmental Allies to work this Saturday, August 24. To prepare for the concrete pour on Saturday, the contractor will continue working on the south lane between Solomon and Australia. The pour will begin at 6 a.m.

Weather permitting, the contractor plans to start pouring driveways for residents on the south lane on Tuesday and Thursday. Additionally, they will continue laying out the storm system between Australia and Senate.

Traffic will be tight over the next couple of months, and we appreciate your patience. The contractor is making every effort to complete the project by the end of February, which is a significant advance from the original end date of June 2025.

Next week, the contractor will also focus on repairing sprinkler systems for residents and forming sidewalks and curb inlets between Solomon and Ecuador.


Revise Temporary Mailbox Bank Location
08/22/2024
Temporary mailbox banks will be set up on the northwest corner of Australia and Congo.  The temporary mailbox bank located on Equador St. will remain in place until the sidewalk is installed on the northside of Congo Lane.

Congo Lane Update August 16
08/16/2024

City Manager has approved Environmental Allies to work on the weekend of August 17-18.

Saturday:
Pour 60 cubic yards of concrete at 5,000 psi for half of the Solomon & Congo intersection at 8:00 a.m.
Pour 20 cubic yards of concrete at 3,500 psi for the sidewalk on EB Congo between Equador & Solomon.
Saw cut the new paving from Friday's pour at the Congo & Solomon intersection.
Conduct general housekeeping.

Sunday:
Saw cut the new paving from Saturday's pour at the Solomon & Congo intersection.
Sweep and clean the intersection, open it to traffic, and backfill the sidewalk.
The intersection between Equador and Solomon will be completed by August 19th, and both lanes will be opened to the public.

Starting August 19th, the intersection between Solomon and Australia will be closed to the public, except for residents within this block. The contractor will proceed with installing the new 8” water line, storm system, paving on both lanes, and sidewalks. Temporary mailbox banks will be set up on the northwest corner of Solomon and Congo. The contractor will notify all affected residents. Lane closures for this section may last between 6 to 8 weeks, weather permitting.


Congo/Solomon Intersection To Be Completely Closed
08/14/2024
The intersection of Congo and Solomon will be completely closed starting at 7am on Thursday, August 15 and will reopen on Sunday, August 18. This is required for the intersection to be ready for school starting on the 19th.

Update for August 9, 2024
08/09/2024

The contractor made good progress this week. They will be pouring concrete on Saturday, August 10. They will also pour concrete early next week. Congo from Solomon to Equador will be completely open no later than August 18, and likely a few days earlier. This will greatly help the flow of school traffic.

People driving to/from Jersey Village High School or Post Elementary are strongly encouraged to avoid Congo Lane from Seattle to Solomon. They should utilize other streets, such as Singapore or Seattle if coming from Senate Avenue, to Congo Lane from Solomon St.

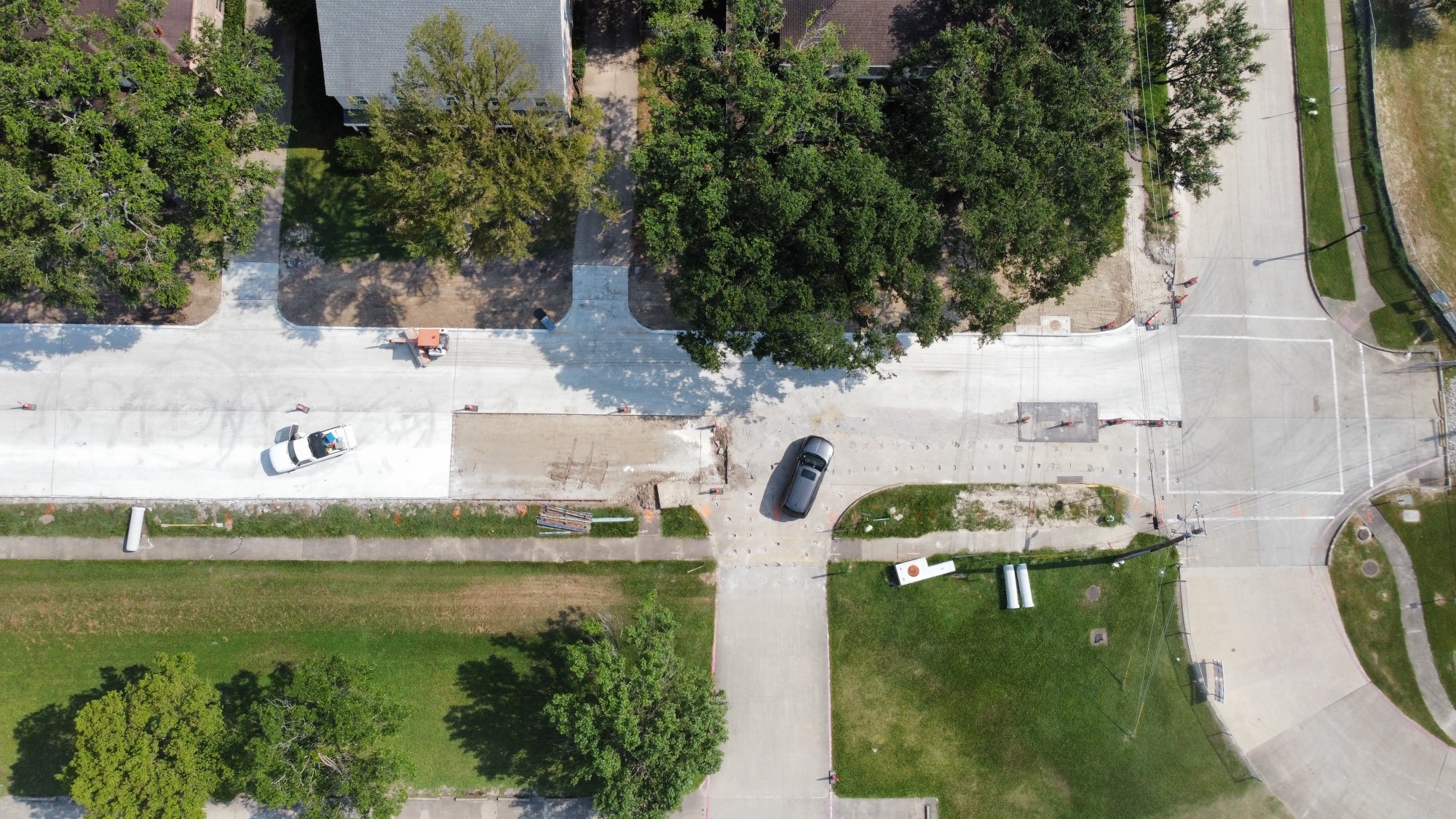

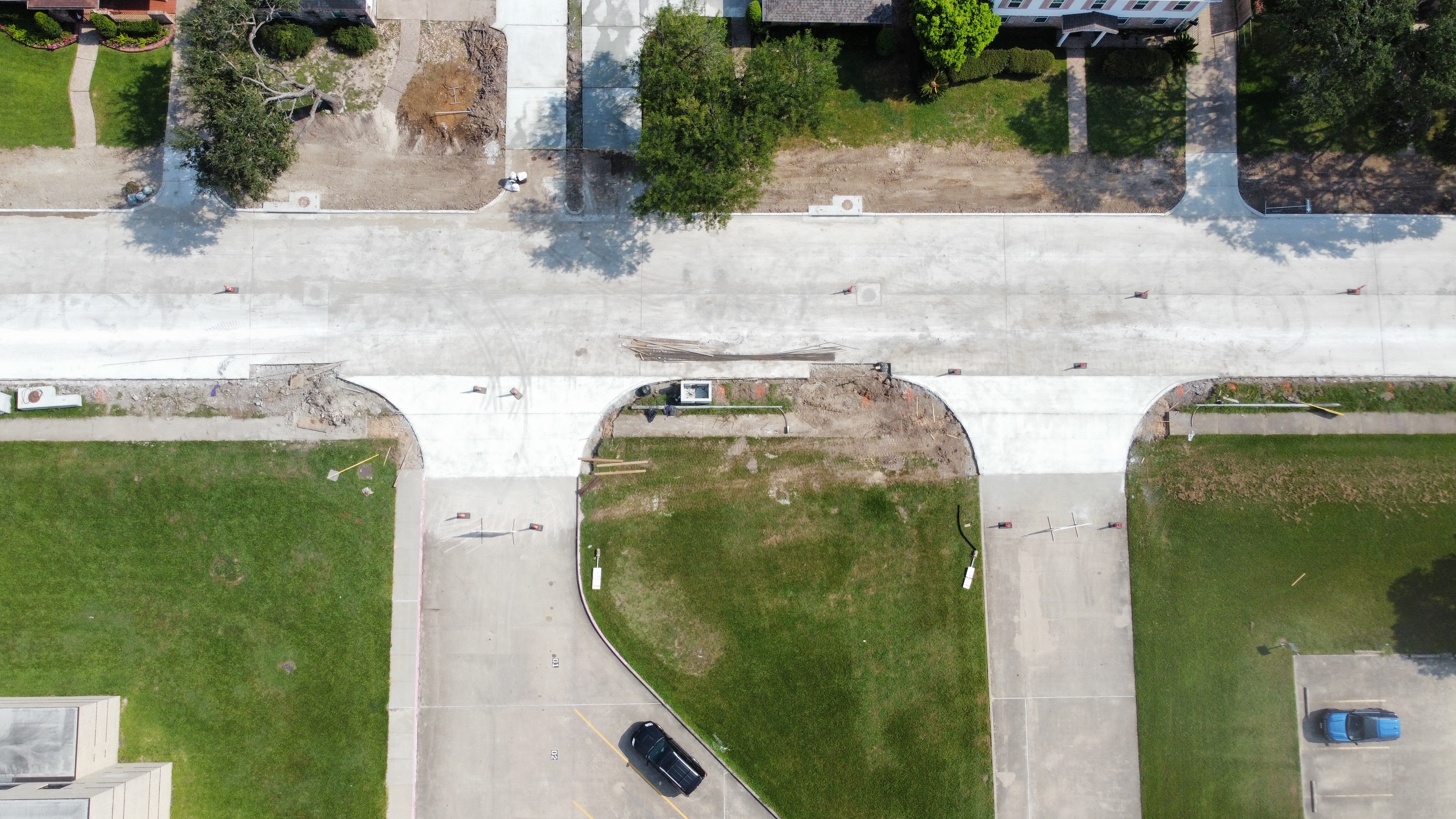

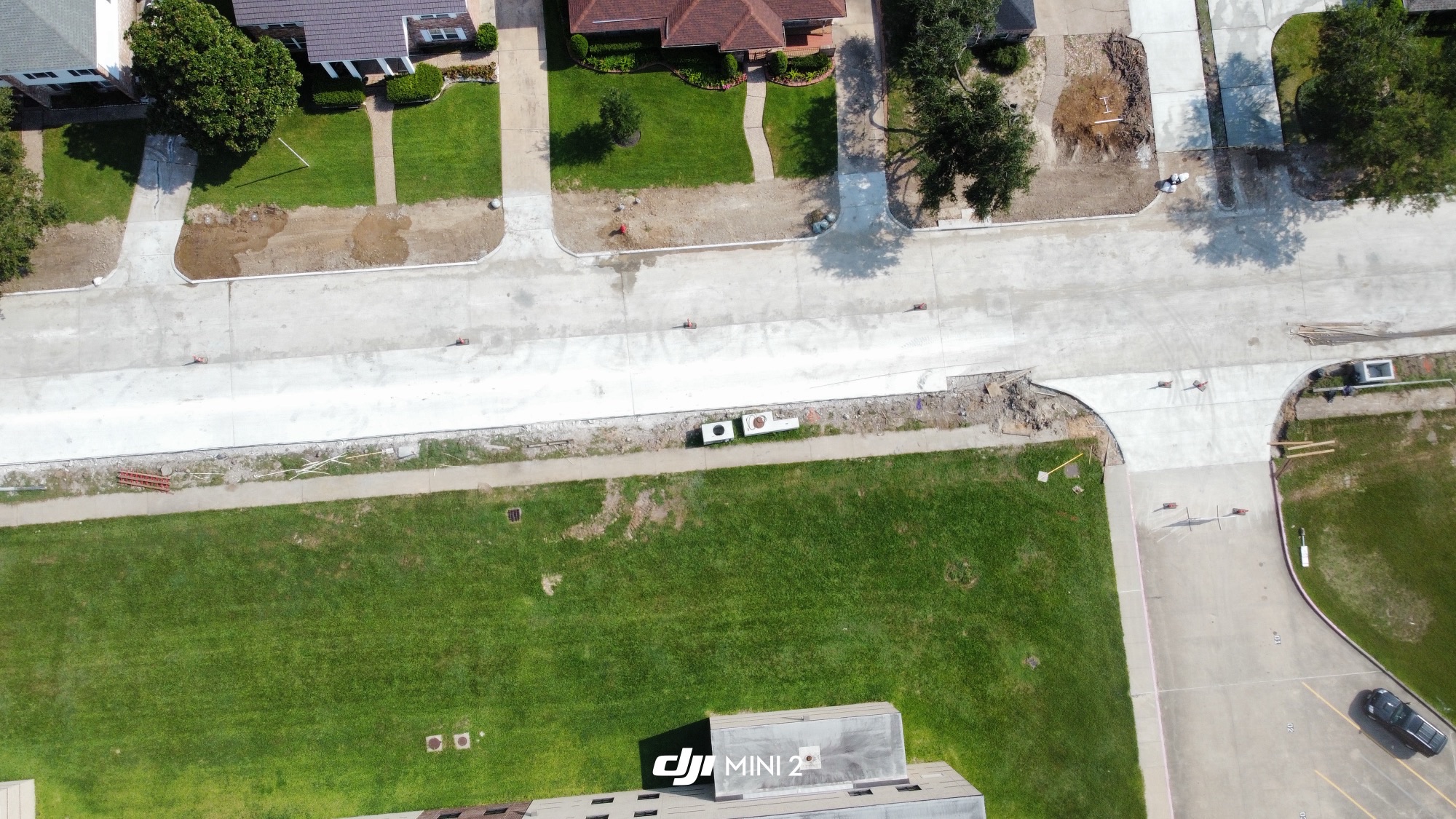

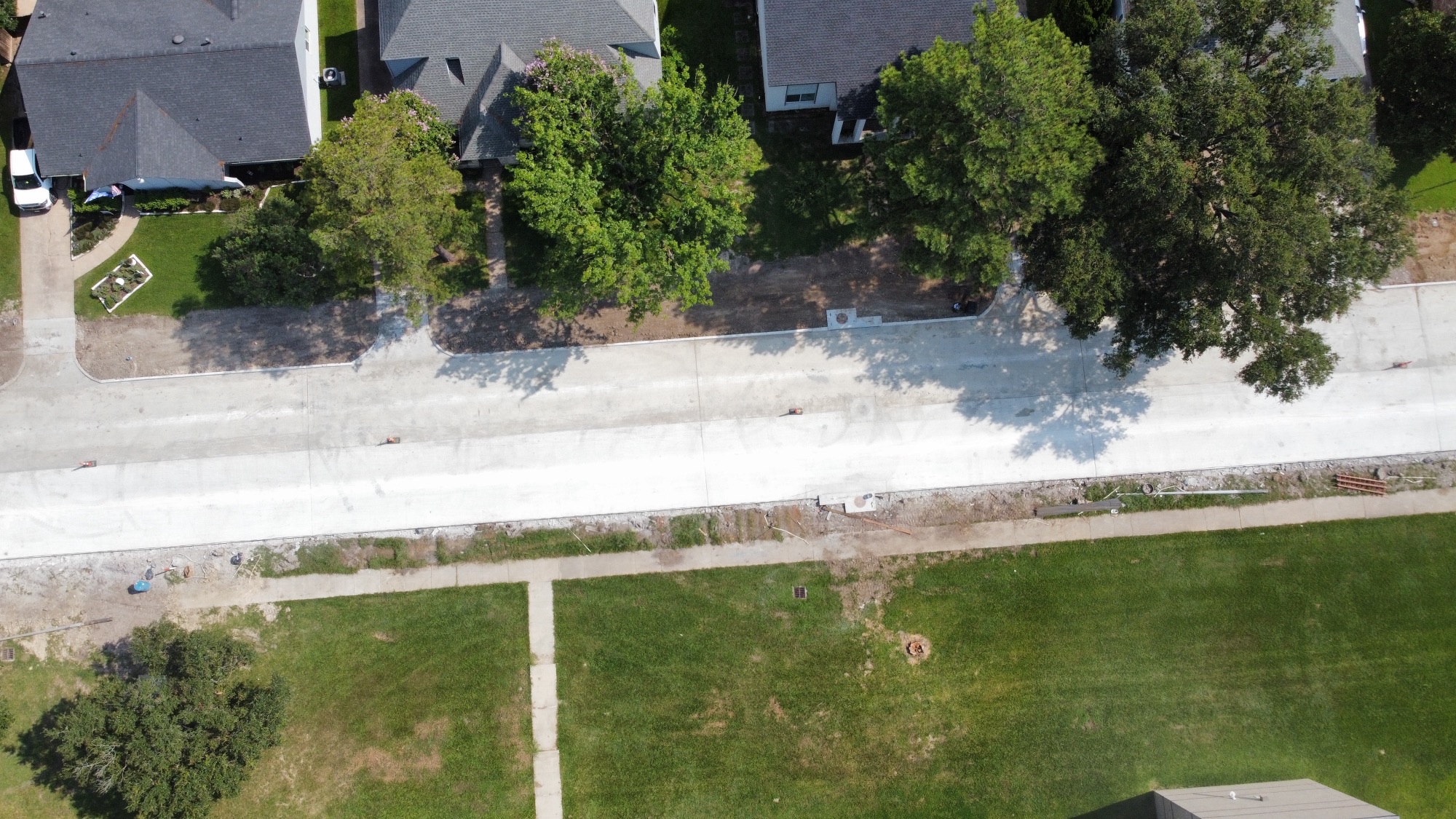

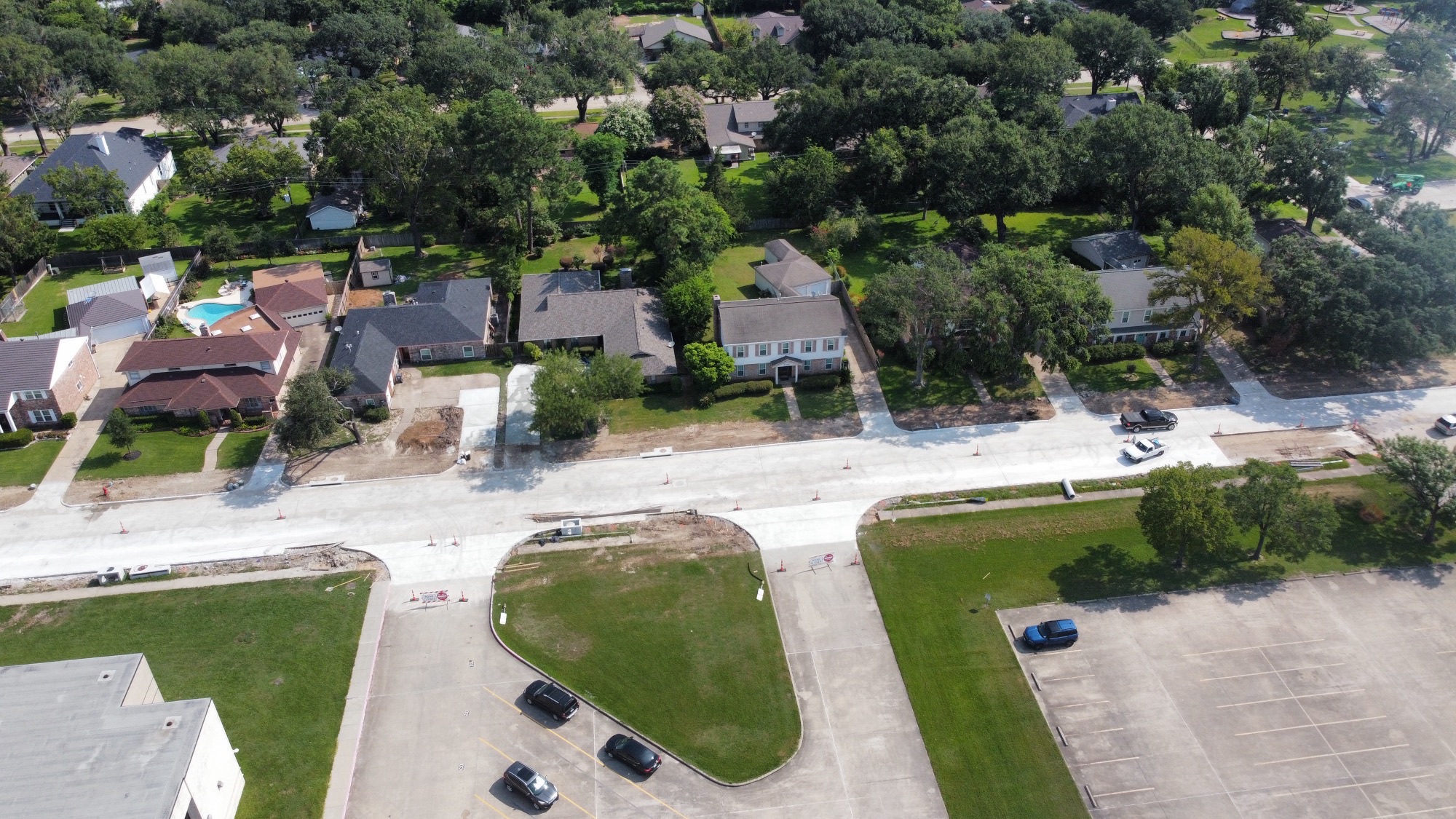

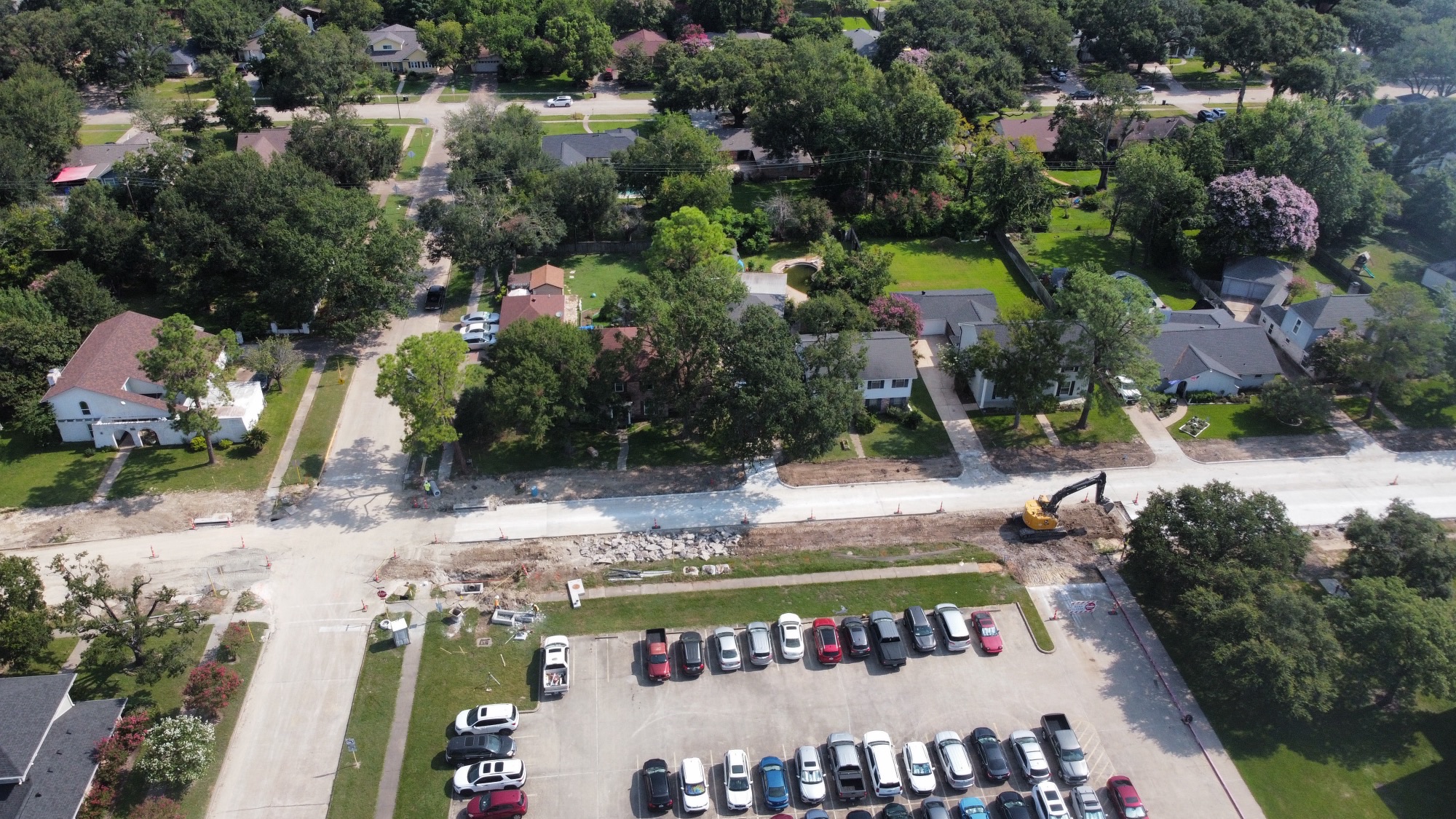

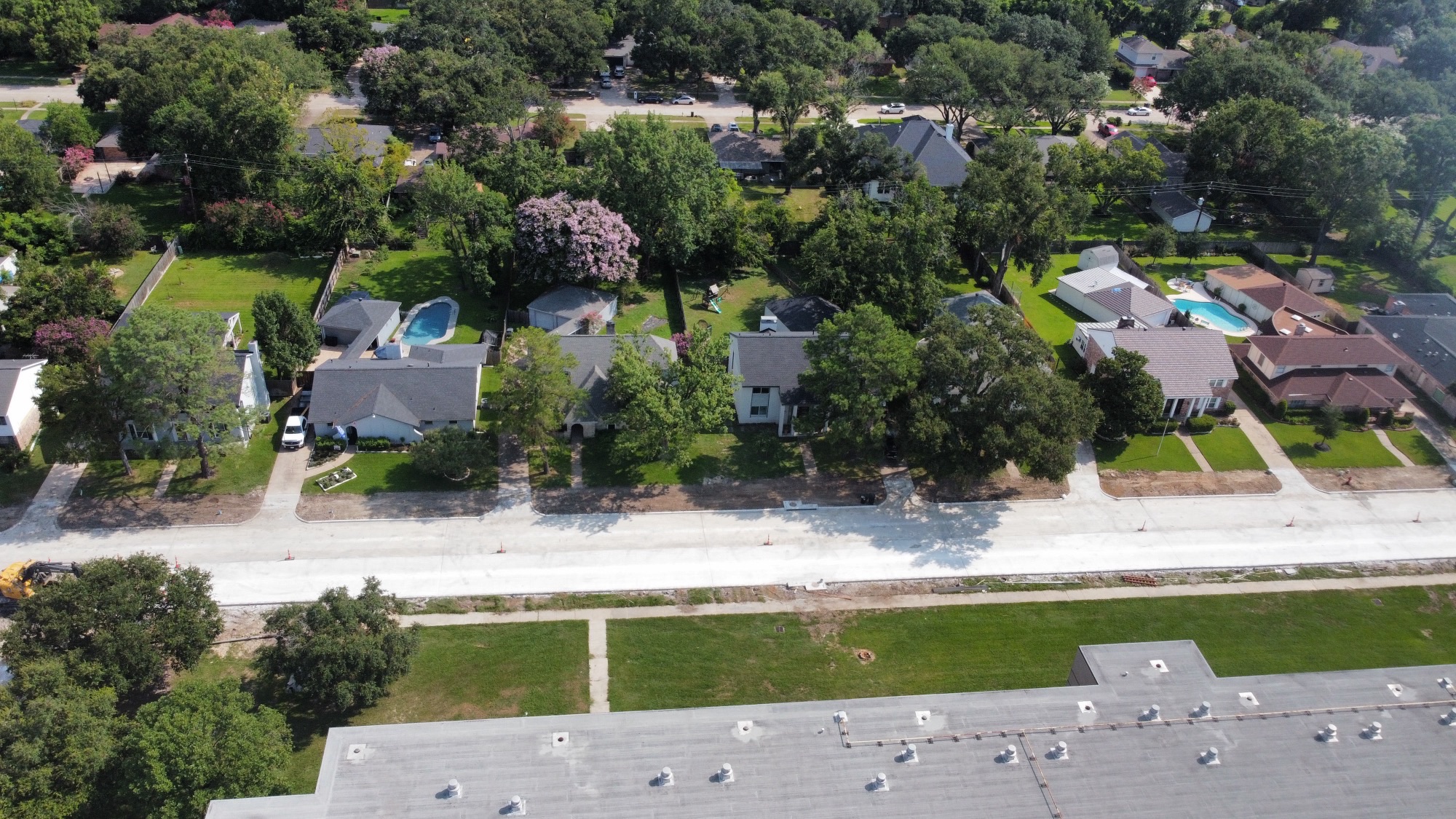

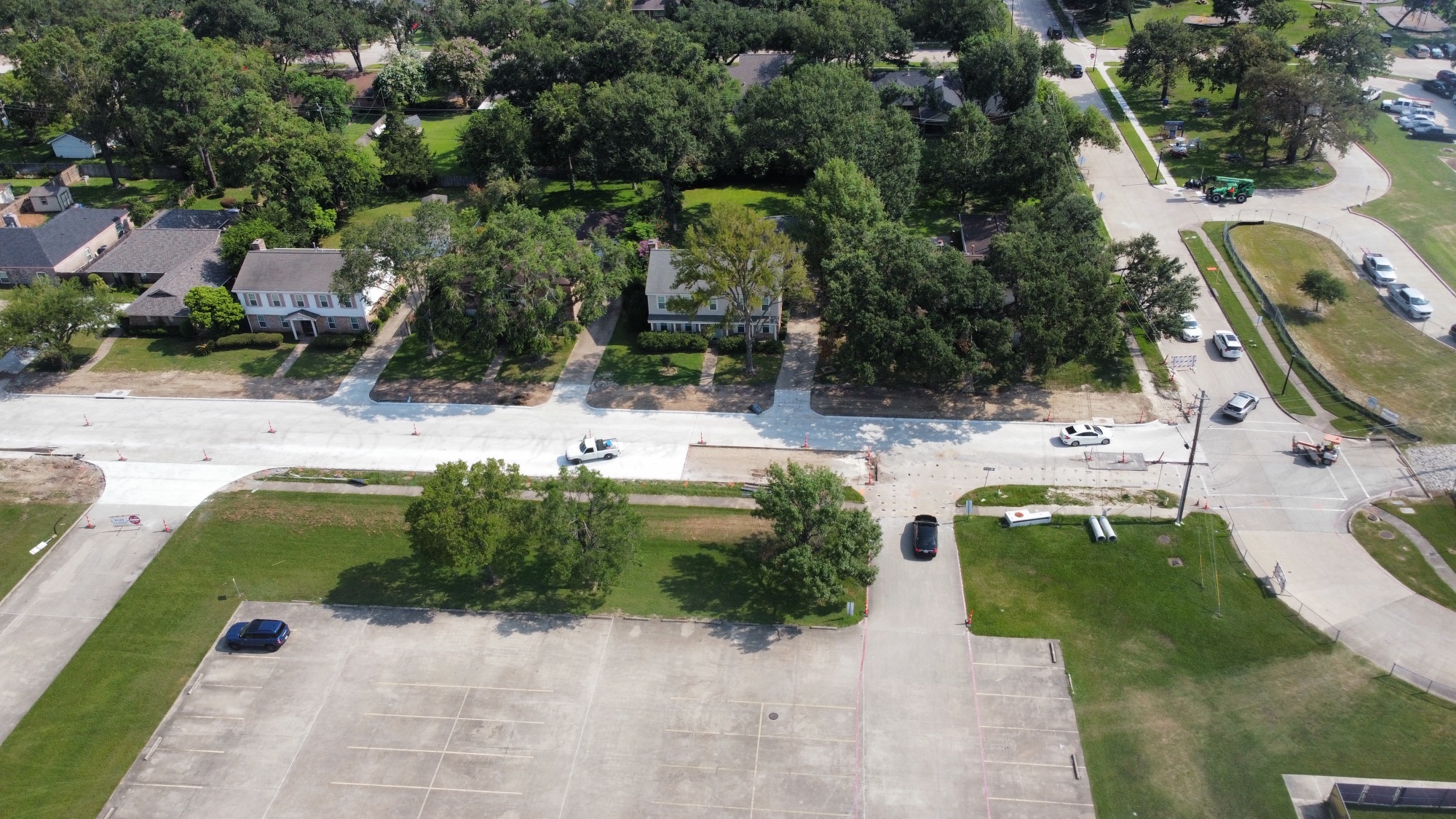

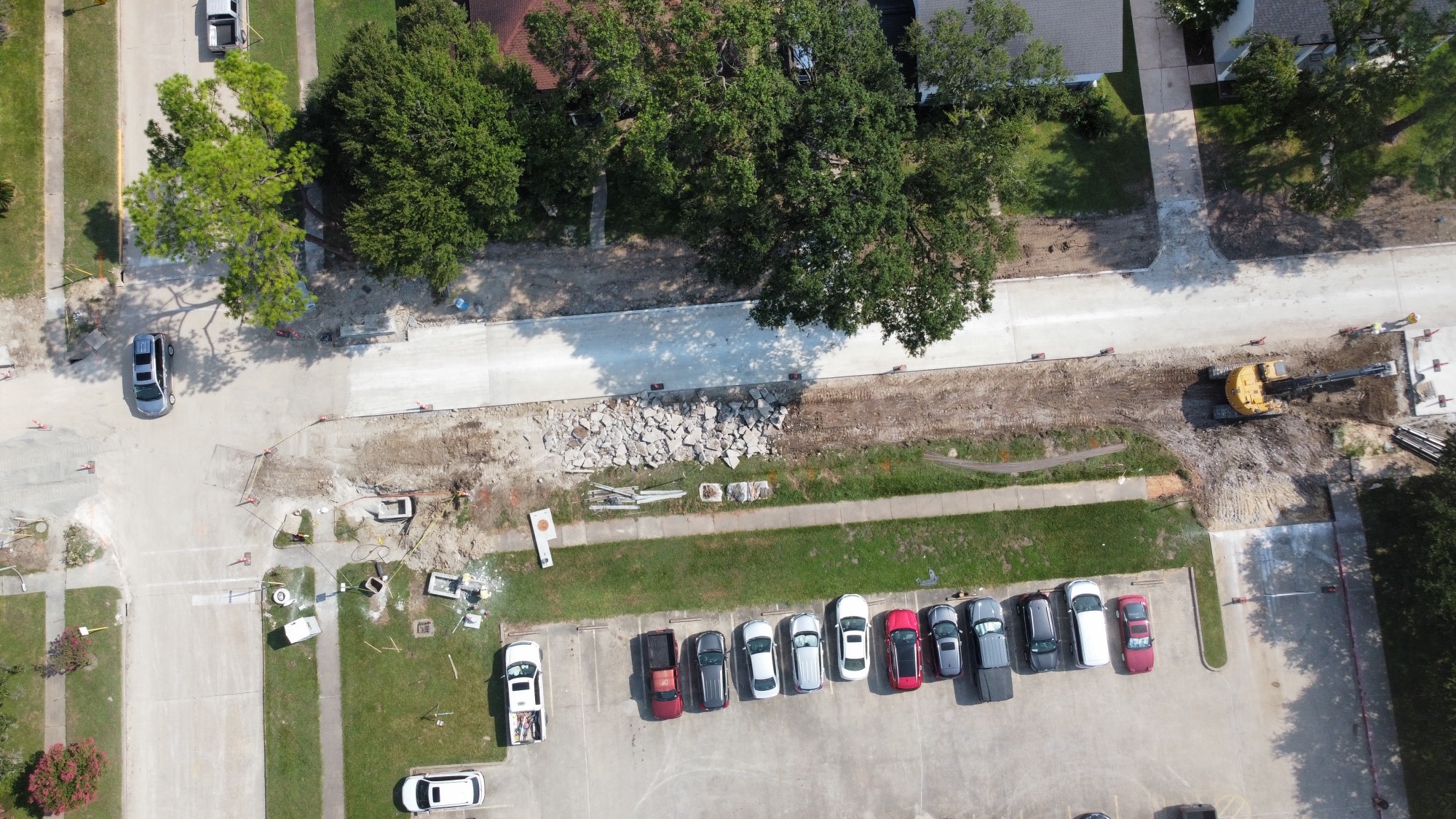

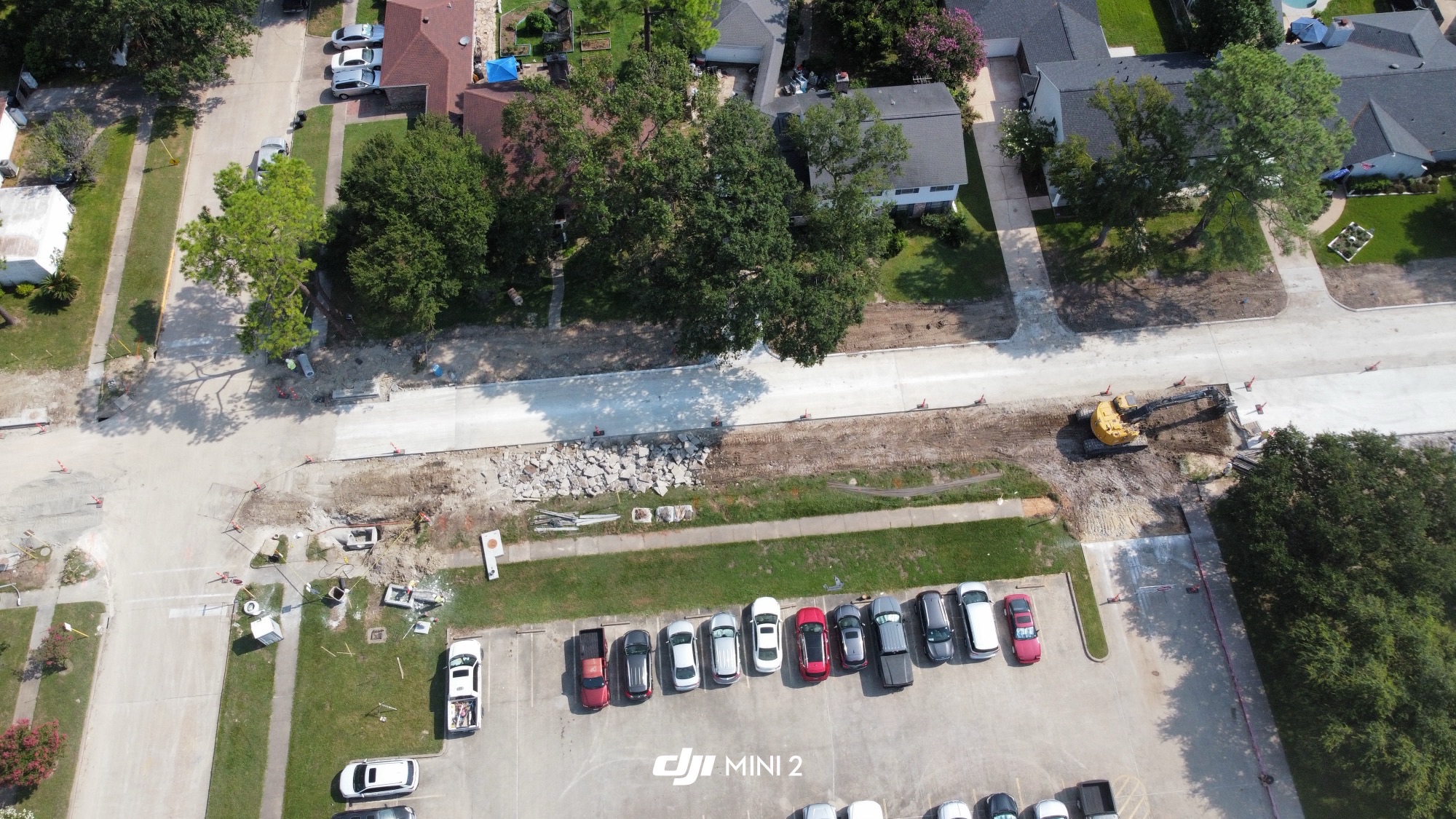

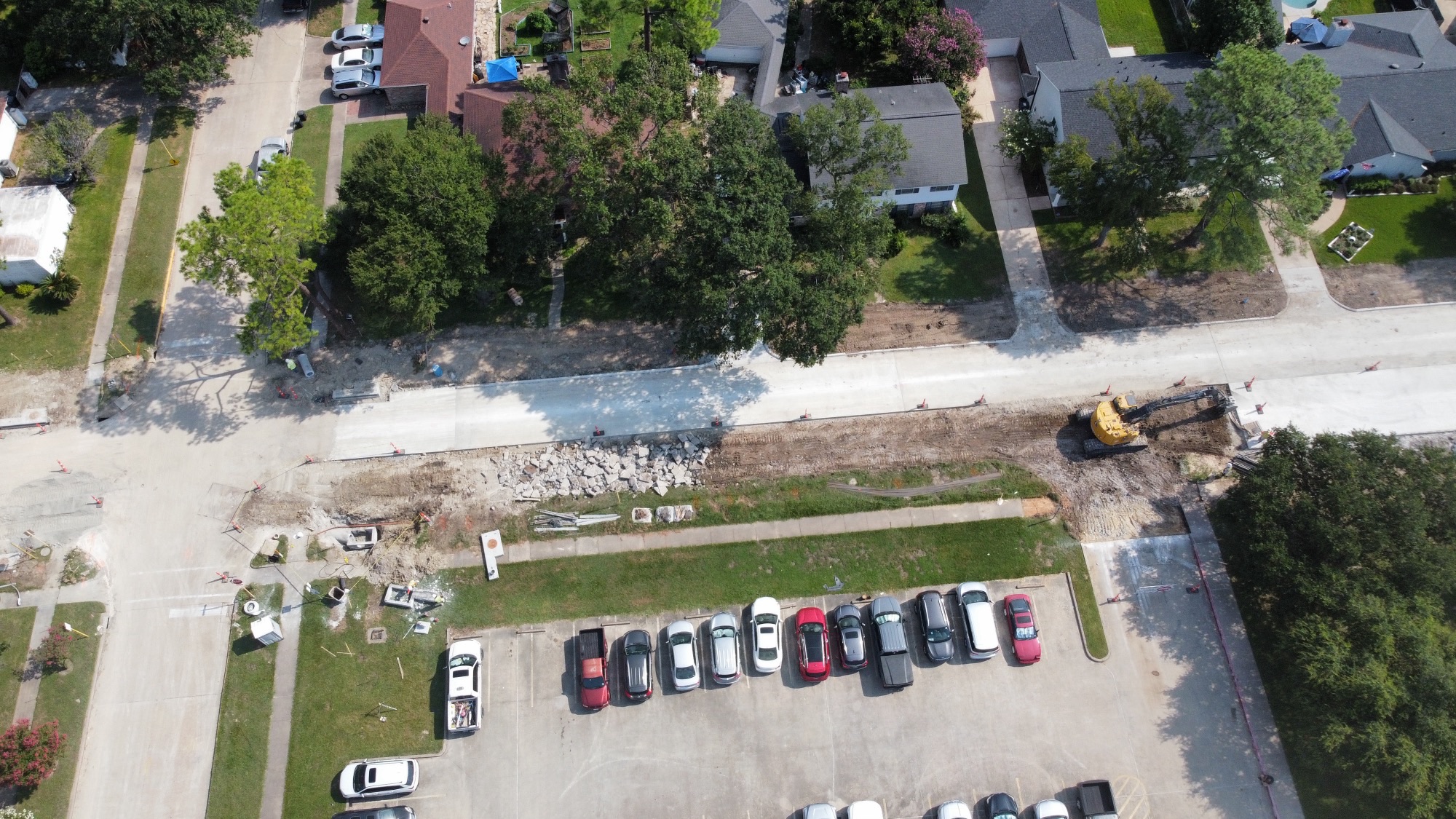

Here are some drone photos of the project so far. Click on the images for larger versions.

Construction Progress Construction Progress

Construction Progress Construction Progress Construction Progress

Construction Progress Construction Progress

Construction Progress Construction Progress

Construction Progress Construction Progress


Congo Lane Update Notification 8/3/24
08/02/2024

The City Manager has approved Environmental Allies to complete the concrete pour for the south lane this Saturday. This work aims to finalize the lane’s surface.

The Contractor, City Project Manager, and School Board have collaborated to devise a bus re-route plan for opening day, addressing potential access issues. The School Board is pleased with the progress and has prepared a contingency plan.

Currently, CenterPoint Energy is onsite relocating conflicting gas lines beneath the new storm system. The storm system’s pipe work is about 75% finished, pending the completion of the gas line relocation from Congo/Australia to Congo/Senate.

Residents are requested to park vehicles in driveways to ease traffic congestion and ensure safety during construction. The new 8" water line installation is 25% complete, with 15 residents now served by this line. Work on the water line will resume after the completion of construction from Equador to Solomon and after CenterPoint finishes their work.

Thank you for your patience and cooperation.


Saturday Work Approval 8/3/24
08/02/2024
The contractor has been granted Saturday work approval for 8/3/24 to pour concrete and finished the south lane.

Congo Lane Traffic Update
07/30/2024

We want to provide an update on the ongoing construction project in our area. Digco, working on behalf of CenterPoint Gas, is currently lowering several gas service lines along Congo Lane. This work has led to increased traffic congestion and potential safety concerns. Additionally, yesterday Digco accidentally struck the main waterline, and another contractor has since been added to the site, further contributing to the traffic issues.

To help alleviate these problems and ensure everyone’s safety, we kindly ask that you park your vehicles in your driveway until the project is completed.

Please be aware that the contractor is also managing stormwater control to prevent flooding and handle runoff effectively. We appreciate your understanding and cooperation as we work to improve our community and expedite this project.

Thank you for your patience.


Saturday Work Approval
07/25/2024
The contractor has been granted Saturday work approval for 7/27/24 for concrete preparations.

Congo Lane Update Notification 7/25/24
07/25/2024

Water Line

  1. Approximately 1,500 LF 8" installed; 50% complete; pressure test passed
  2. 15 Residents are receiving service from the new 8" line
  3. Water line installation will stop and focus on finalizing the South lane between Equador and Solomon
  4. FDC and HS domestic tie-in is completed as of 7/24/24



Storm System

  1. 12 driveways poured
  2. North lane completed except for panels at the intersection of Solomon/Congo
  3. Weather permits, contractor only needs 14 days to complete the south land before August 19th.  Contractor will request to work on Saturdays to meet schedule. Critical dates will be discussed in weekly meeting moving forward.
  4. Approximately 1500' of storm pipes have been installed (24"-30") along the center of Congo and laterals for future inlets
  5. No issues with gas line crossing encountered as shown on CenterPoint Gas drawing.

Trash/Recycling services

Public Works has notified GFL about the frequent missed pickups.  We were told that this was relayed to dispatch for further attention.


Project update for 7/18/24
07/18/2024
Work crews prepped driveway areas on the north side of Congo, removed trench boxes from the bore area at Congo and Solomon, and began backfilling both sides. They resolved a water leak at 15530 by bypassing the existing connection and replacing the pipe to the house and installed an additional 40' of 8" waterline west of Solomon. The crew also installed 120' of 8" waterline, replaced 20' of 2" irrigation lines, and removed 87' of 4' sidewalk. A subcontractor placed fiber optic next to the curb on the south side of Congo in front of the school. Rebar was placed in front of the driveways, and 160LF of 24" RCP was installed west of Solomon. They placed another 100' of 8" waterline and replaced 14' of 2" PVC. Three sections of pavement were poured, with plans to pour more on Friday, weather permitting. In the center of the street west of Solomon, 48 LF of 24" RCP and two junction boxes were installed.  Centerpoint/DigCo worked to lower the gas line at the intersection of Australia, resolving issues with exposed excavation.

Saturday work approval 7/13/24
07/11/2024
The contractor has been granted Saturday work approval for 7/13/24 to conduct pipe installation and concrete preparations.

Project update for 7/11/24
07/11/2024
Pressure testing was conducted on the 8” water line between Equador and Solomon. Demolition and paving were carried out west of Solomon Street. New 24” RCPs were installed above area storm sewer B and the subgrade was cut for new driveways. Weather permitting, the north lane will be paved before the start of next week, and 80% of the driveways between Equador and Solomon will be completely poured. Work on the 8” water line will continue once ductile iron pipes are installed under the road. The contractor is expected to begin demolition of the south lane between Equador and Solomon next week.

Congo Lane Update Notification 6/26/24
06/26/2024
To be ahead of schedule, the contractor requested to work this coming Saturday for concrete pour at 9 am.  The contractor has been granted permission to conduct work activities this Saturday 6/29/24

Weekly updates, June 12-19
06/21/2024

Based on the weekly updates provided from June 12-19, here's a summary of the progress made:

Waterline:

  • Location: First section up to Solomon St.
  • Activities Completed:
    • Installed 972 LF of 8” water line
    • Installed 2 fire hydrants
  • Upcoming Work:
    • Continuation of water line installation

Stormwater System:

  • Activities Completed:
    • Installed 869 LF of 24”-30” RCP (Reinforced Concrete Pipe)
    • Installed 3 manholes
  • Upcoming Work:
    • Further storm sewer installation

General Progress and Notes:

  • Construction Schedule:
    • Contractors worked half days on Wednesday and Thursday due to afternoon showers.
    • Additional work scheduled for Saturday, June 22nd from 7am-5pm to maintain schedule.
  • Environmental Measures:
    • Sods were installed along curbs to prevent silt from washing into the street.

Sidewalk and Pavement:

  • Activities Completed:
    • Mobilization and staging area established
    • Mailbox banks installed
    • Removed 1110 LF of sidewalk
    • Removed 890 LF of pavement on the North Lane
  • Upcoming Work:
    • Further sidewalk and pavement activities

This summary encapsulates the key activities completed during the week of June 12-19, highlighting progress made in various aspects of the project and outlining plans for the upcoming period.


Weekly updates, June 3-12
06/17/2024

Weekly updates, June 3-12

Work on Congo is moving right along and on schedule.  Below is the progress made since June 3rd.  NOTE:  Weekly construction meetings are on Thursdays and quantity updates are from Thursday-Thursday.

Sidewalk and Pavement:

  • June 3-12: Mobilization, staging area established, mailbox banks installed, 725 LF of sidewalk removed, and 550 LF of pavement removed on the North Lane.

    Water Line:

  • June 6-12: Mobilization, 700 LF - 8” water line, and 1 fire hydrant installed.

    Stormwater System:

  • June 6-12: Mobilization, 356 LF – (2- 30” RCP), and 2 manholes.

Over the next week, there might be a delay due to weather conditions.  Thank you for your ongoing support and collaboration.



Tim Nguyen, EIT/PM

tnguyen@jerseyvillagetx.com


Work starts Monday, June 3
05/31/2024
Starting Monday, June 3rd, Congo Lane will undergo a drainage improvement project aimed at ensuring efficient water management, reducing flooding risks, and enhancing overall infrastructure.
While we strive to minimize inconvenience, please expect temporary changes such as noise, increased construction traffic, and limited access to certain areas. We appreciate your patience and understanding during this time.
We will keep you informed about project milestones, any updates (see attached construction schedule), and potential changes throughout the duration of the project. Please feel free to reach out to me for any questions or concerns you may have.
We appreciate your cooperation and understanding as we work towards improving our community's infrastructure. Together, we can make this project a success and enhance the quality of life for all residents.
Thank you for your attention to this matter.
Sincerely,

Tim Nguyen, EIT/PM

Department of Public Works,

City of Jersey Village

16327 Lakeview Drive

Jersey Village, TX, 77040

Office: (713) 466-2148

tnguyen@jerseyvillagetx.com


Congo Lane Construction Schedule
05/30/2024
Congo Lane Construction Schedule 5-30-2024.pdf

Congo Lane Drainage Improvements Construction Drawings
05/30/2024

CONGO LANE DRAINAGE IMPROVEMENTS SHT 1-23.pdf

CONGO LANE DRAINAGE IMPROVEMENTS SHT 24-44.pdf

CONGO LANE DRAINAGE IMPROVEMENTS SHT 45-67.pdf


Town Hall Meeting May 20 With Work To Begin June 3
05/16/2024

There will be a Town Hall Meeting for this project on May 20, from 6-8pm at the Civic Center. Residents can come to learn more about the project and get all of their questions answered.

A Notice To Proceed has been issued to the contractor. Work will begin on June 3, 2024.



Here is an overview of the upcoming project related to Congo Lane:

  1. New Road: The road widening project will involve expanding Congo Lane to increase the width of lanes (existing 27 ft. to new 33 ft.) and improve traffic capacity. This will help alleviate congestion, reduce travel times, and enhance safety for motorists, pedestrians, and cyclists.  This may involve temporary road closures or detours. We will provide advance notice of any disruptions and alternative routes.
  2. New Sidewalks: The sidewalk improvement project will involve the installation of new 5 (ft.) sidewalks on Congo Lane where they are currently lacking or in need of repair. These new sidewalks will provide safe and convenient pathways for pedestrians, improving connectivity throughout our neighborhood.  We will make every effort to minimize inconvenience.
  3. Waterline Replacement: The water line replacement project will involve replacing aging water pipes with new ones to improve water flow, pressure, and quality in our community. This will help prevent leaks, reduce the risk of service disruptions, and ensure the delivery of safe drinking water to your home.
  4. Drainage Improvements: The drainage improvement project will involve the installation of new drainage systems, including pipes, and inlets, to improve water flow and reduce the risk of flooding in low-lying areas of our community.  We will strive to complete the work efficiently and minimize disruptions.

We understand that these projects may cause temporary inconvenience, and we appreciate your patience and cooperation as we work to improve our community. We will keep you informed throughout the process and provide updates on any changes or developments.  If you have any questions or concerns about this project, please do not hesitate to contact me; my information is below.  Your feedback is important to us, and we are here to address any issues you may have.  Thank you for your understanding and cooperation.


Pre-Construction Meeting Held Work To Commence Soon
05/09/2024

On May 8 we had a pre-construction meeting with the contractor. They have requested to begin work the week of May 13. We are currently evaluating the request. If work does start the week of May 13 it would begin on the Senate Ave end of Congo. Residents impacted will be notified before work begins.

Work on Congo between Equador and Solomon would not start until June 1.

There will be a meeting for residents of Congo Lane on Monday, May 20th at 6pm at the Civic Center to discuss the project and answer questions. City staff and the contractor will be there to answer questions.

You can also use the form below to ask your questions as well. We will respond to questions via email and post the questions and answers on this page as well.


Congo Lane Project Awarded To Contractor
04/23/2024

As part of the 2023 Bond Referendum the citizens of Jersey Village approved bonds for street projects, one of which was the Congo Lane Project.

This project was designed by Garza EMC and includes new street, sidewalks, storm sewer, water line, and street lights for Congo Lane from Senate Avenue to Equador Street.

The project was placed out to bid in March 2024. The following bids were received:

Bidder Bid Amount
Environmental Allies $2,950,512
R Construction $3,672,610.05
Cracon Inc $3,786,693.10
Teamwork Construction Services Inc $4,034,834
iCon GC LLC $4,260,000
MC2 Civil LLC $4,576,184.50
Conrad Construction Co LTD $4,850,523



During the April 22, 2024 City Council Meeting the City Council awarded the project to Environmental Allies.

Work is expected to begin at the conclusion of the 2023-2024 school year along Congo Lane from Solomon to Equador. That section of road is anticipated to be completed before the 2024-2025 school year begins in mid-August.


Use this Form to sign up for email updates

FREQUENTLY ASKED QUESTIONS



Will storm water pipes be enlarged?



clipYes pipes will be enlarged, and additional piping will be added with the goal to discharge excess water off of the streets and into the drainage system. This improved design system is for 2-year storms.

Will sidewalks be updated?



Sidewalks will be replaced on both sides of the street; tree roots will be taken into consideration. We will ensure compliance with American Disability Act (ADA) requirements and will request an inspection from the Texas Department of Licensing and Regulation (TDLR).  Additionally, there will be new sidewalk along Congo Ln. for the empty lot located at the intersection of Australia St. and Congo Ln. Future sidewalk along Australia Ln. will be part of the 2025 Solomon St. and Australia St. Capital Improvement Plan.

Will the street cut become the new center of the street?



No, they cut beyond the midpoint to place their forms, stabilized materials and create a smooth transition to phase two.

How deep is the cut for the concrete pour?



The depth will be 6 inches. After the concrete is cured (approximately 3-5 days) residents can turn in/out of their driveway.



I have trouble turning into my driveway, what should I do about this?



Contractors are experienced in handling various construction and access-related issues. They can assess the situation quickly and provide practical solutions to improve driveway access.  Our inspector can also work closely with the contractor, to ensure smooth access to the property.  Please feel free to reach out to contractor, our inspector, or myself if you have this issue and we can help you get in/out of your driveway.

Can we put gravel in the gap?



We cannot mix materials in the gap because that may hinder inspection approval.



What other type of inconveniences or obstacles can we expect?



  1. No sidewalk until it’s poured
  2. Alternative methods to mail service/ package deliveries
  3. Trash services
  4. Mowing services



What are we doing with mailboxes?



Mailbox: Temporary boxes will be place at two locations in phases.  One will be located at the intersection of Congo Ln. and Australia St. and the other will be at the intersection of Congo Ln. and Equador Ln. for residents to utilize for their mail services. We have notified the Post Office of this alternative location.  Also, the contractor will work with each resident to replace the mailbox with like or better upon completion of construction.


Are we going to be given periodic updates regarding the status and phase of the project?



Periodic schedule updates will be posted on the JV website as well as notifications from the Contractor.


Will there be traffic control during construction time?



Flagging and traffic control coordination will be ongoing throughout the construction.


Is the speed limit going to change?



No


Are the sidewalks going in at 4 foot?



New sidewalks will be a minimum of 5’ wide.


How will I access my house the day of the pour?



Residents may have to walk a few houses back towards a dry area, contractor can coordinate pass through if needed.


Will we be notified when concrete is poured?



The contractor will notify all residents a few days before the concrete pour.


Will my trash be picked up?



Jersey Village will coordinate garbage logistics with the hauling facility to ensure no missed pickups.


What about lawn companies who park on the street?



They may have to park on Australia St. or Solomon St., but they won’t be able to park on the street.


Is there going to be equipment left at night?



Sub-contractors may leave equipment but only in the construction area, (Not in streets or driveways)


Do I need to have my irrigation system marked in advance?



Yes you can flag them in order to assist however, the contractors will be including this in their assessments prior to any disruption or commencement of construction. They are going to aim to assess irrigation prior to disrupting to ensure they fix disruption. A log of all heads and active systems will be maintained. You can contact the contractor or wait until the contractor does his door to door visit.


What if I have a new sprinkler system that interjects into the ROW?



Contractor will cap the sprinklers at the ROW. This does not guarantee full function of your system. Any sprinklers inside of the ROW will be removed for construction. Each resident is welcome to contact a licensed irrigation company in order to remove any equipment prior and to discuss alternatives to ensure their lawn is maintained.


What happens to our French or area drains that discharges to the street?



The contractor will mark the drain and ensure it remains.
